Can someone confirm Reschedule Lines doesn’t work on the order screen?
Hello,
I am working on testing this feature. I will update you once I am done.
Thanks
Cetec ERP Support
Okay
Hello,
Engineering confirmed today that the button is working.
I can test a specific test case for you if you give me more information.
Thanks!
Cetec ERP Support

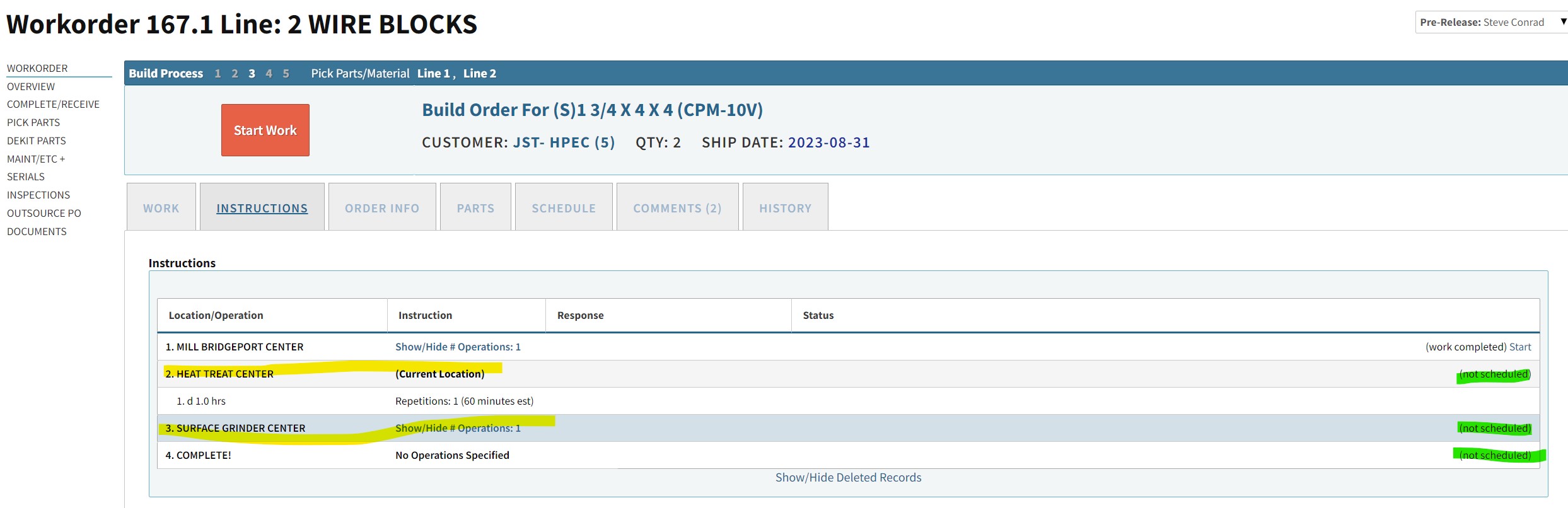

167.1 was supposed to be completed by 2023-08-02 but it seems like no one worked on it.
Can you use that a a test example and see if it will reschedule both line items since there is no work in the other locations.
Did you change the ship date on it? That button reschedules backwards once a ship date is changed.
I just did this and it seems to work but I’m not sure what happened to the previous jobs.
They disappeared on the Gantt chart
Before rescheduling heat treat and grind was there but after i clicked the button they disappeared.
This screen shot is after I rescheduled the lines and the other work locations disappeared
Hello,
Engineering went in to look at this,
They tested Reschedule, and it is working as intended:
It won’t reschedule the “completed” segment. that’s intentional
it also won’t reschedule any labor for locations that are Before where Current Work Location is
(if current work location was Surface Grinder Center, we wouldn’t make an entry for Heat Treat Center)
Can you let me know if this clears up the issue? If not, it may help me to know what you are expecting to see vs. what is happening. Sorry for any frustration.
Thanks!
“It won’t reschedule the “completed” segment. that’s intentional” , But the other locations doesn’t have time or completed status.
The current location is HEAT TREAT CENTER and from what you are saying heat treat is before grinding work center and it didn’t appear on the schedule.
I assumed if you click reschedule button it would reschedule any orderline that isn’t completed.
Maybe i am not understanding what the reschedule lines button is for.
Basically the issue is why did it take the other two operations out of the Gantt chart? And now if you go on the Gantt chart it says they are part of the unscheduled lines. But we clicked the reschedule lines expecting it to schedule it and take it out the Gantt chart.
Basically the issue is why did it take the other two operations out of the Gantt chart? And now if you go on the Gantt chart it says they are part of the unscheduled lines. But we clicked the reschedule lines expecting it to schedule it and take it out the Gantt chart.
